Building a Barndominium in Florida: Timeline Guide
Barndominiums, Florida Homebuilding, Construction Timelines
How Long Does It Take to Build a Barndominium in Florida?
If you own land in Florida and you’re planning a barndominium, you’ve probably seen promises of “move-in ready in 3–4 months.” That sounds great—until you realize those estimates usually only cover the steel shell, not the real, full build from first sketch to certificate of occupancy. This guide lays out the entire barndominium construction schedule in Florida, with honest time ranges, what actually causes delays, and how LK Homes manages realistic timelines so you can plan housing and financing without guessing.
The Real Answer: 8–12 Months for a Complete Florida Barndominium
Let’s start with the blunt truth. In Florida, a realistic barndominium build timeline from first design meeting through certificate of occupancy is typically 8–12 months. That includes:
Pre-construction design and engineering
Permitting and approvals
Site clearing and prep, foundation, and utilities
Steel shell erection and roofing
Insulation, mechanical rough-in, interior framing, drywall, and finishes
Exterior finishes, final inspections, and certificate of occupancy
The 4–6 month “fast barndo” stories you hear online usually refer to one thing only: the shell. The steel goes up quickly—no argument there. But if you want a livable, inspected, code-compliant home, the shell is only part of the story. LK Homes is very clear about this from day one because your lease, temporary housing, and financing draw schedule all depend on the whole timeline, not a marketing number.
Phase 1: Pre-Construction Design & Engineering (6–10 Weeks)
Before a permit application can even be submitted, your barndominium has to be fully designed and engineered to meet the Florida Building Code and your specific county requirements. In Florida, this pre-construction phase realistically takes 6–10 weeks when done correctly.
Architectural floor plan and elevations customized to your land, wind zone, and lifestyle
Structural engineering for your steel shell, slab, and connections, stamped by a Florida engineer
Mechanical, electrical, and plumbing (MEP) plans coordinated with your floor plan
Main delay triggers in this phase: indecision and redesign. Every time a floor plan changes after engineering has started, you’re effectively restarting part of the clock. At LK Homes, we push hard to finalize the floor plan before engineering begins. It’s not because we’re inflexible; it’s because we’ve seen mid-stream changes add 4–6 weeks with a few pen strokes.
Phase 2: Permitting in Florida (3–8 Weeks on Average)
The good news: Florida’s permit processing has improved. Statewide reforms and digital platforms have pushed the median building permit processing time for residential projects in many jurisdictions down to around 25 days in 2025. Some municipalities and counties are rolling out online portals, standardized forms, and even AI-assisted reviews to keep things moving.
The honest reality, though, is that Florida county permitting timelines vary significantly:
Rural counties like Marion and Levy often process permits faster, especially as their systems modernize.
Urban and coastal counties can take longer due to volume, floodplain checks, and stricter review layers.
LK Homes typically sees 3–8 weeks from permit submission to approval, depending on the jurisdiction and whether the reviewer requests revisions. We track each submittal and respond quickly to comments, but some waiting is simply built into the process. Anyone promising “we’ll have your permit in a week” across all Florida counties is not being straight with you.
📌 Key Takeaway: Permitting is faster in 2025 than it was a few years ago, but it is still a variable. A realistic barndominium construction schedule in Florida respects that, rather than pretending it doesn’t exist.
Phase 3: Site Clearing, Prep & Foundation (3–6 Weeks)
Once permits are in hand, we move to the dirt. For most barndominiums, this phase takes 3–6 weeks, depending on the condition of your land and weather.
Site clearing and grading: Removing trees, brush, and topsoil, shaping the pad, and planning drainage—critical in Florida’s rainy climate.
Utilities and access: Driveway, temporary power, water/septic or well, and any required culverts or easement work.
Foundation: Forming, reinforcing, and pouring the slab designed for your specific barndominium and soil conditions.
Delay factors here: heavy rain, soft or mucky soils requiring undercut and fill, and slow utility providers. LK Homes sequences subs and inspections tightly to keep this phase moving, but we also refuse to rush foundations—cutting corners here is how you get slab cracks and long-term problems.
Phase 4: Steel Shell Erection & Roofing (7–21 Days)
This is where barndominiums shine. Once the slab is ready and the steel package is on site, steel shell erection typically takes 7–14 days for a typical Florida barndominium. Add another week on the higher end for complex rooflines or weather interruptions, and you’re still dramatically faster than wood framing.

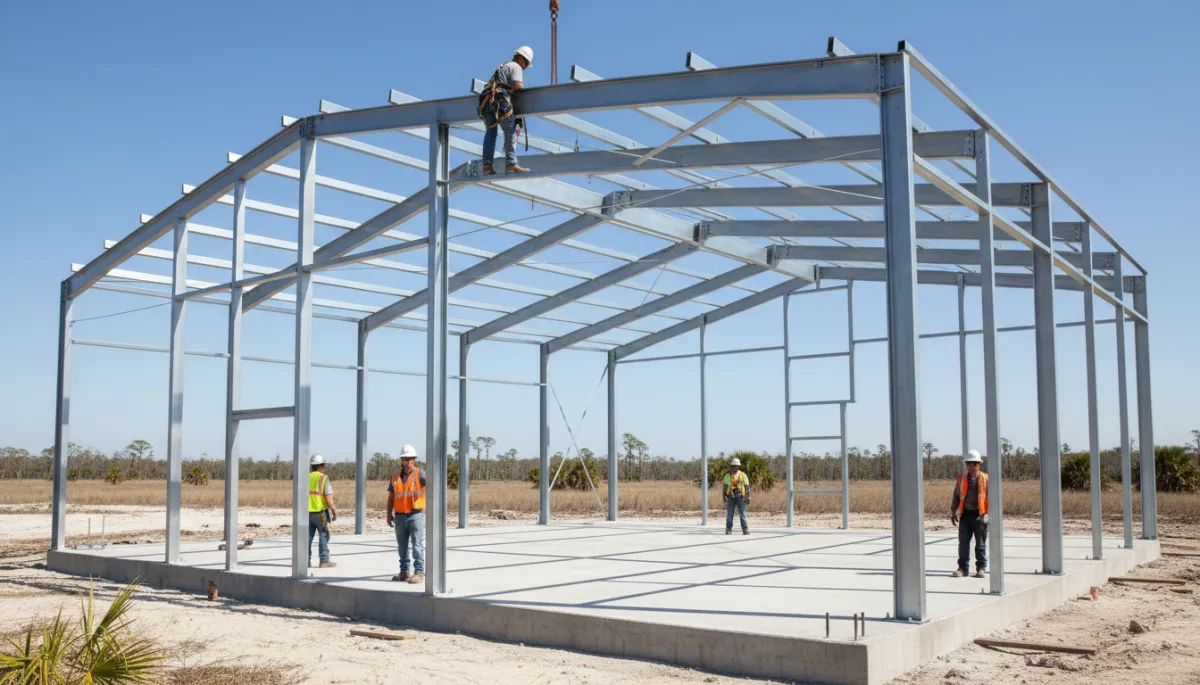

Ground-level view of a barndominium steel frame being erected on a Florida slab foundation,...
Steel shell erection is fast, but it’s only one slice of the total barndominium schedule.
This speed is where the misleading timelines start. Kit suppliers love to quote this phase as if it’s the whole build. Yes, the shell is often done in 4–6 months from order to completion, but that includes fabrication and shipping time—not design, permitting, or interior construction. LK Homes integrates the shell timeline into the entire construction schedule so you see the real big picture up front.
💡 Pro Tip: Ask any builder or kit supplier, “Does your timeline include design, permitting, site work, foundation, interior buildout, inspections, and CO?” If the answer is anything but a clear “yes,” you’re not comparing real timelines.
Phase 5: Insulation, Mechanical Rough-In & Interior Framing (4–8 Weeks)
Once the shell and roof are on, we move inside. For most barndominiums, this stage runs 4–8 weeks and includes several overlapping tasks:
Interior framing: Building out walls, bedrooms, bathrooms, and any loft or mezzanine areas inside the shell.
Mechanical rough-in: Running electrical, plumbing, and HVAC ductwork throughout the structure.
Insulation: Typically spray foam or batt systems tailored to Florida’s heat and humidity.
Here’s where 2025–2026 realities hit: interior finish trades remain the biggest schedule variable in Florida construction. Electricians, plumbers, and HVAC contractors are in high demand statewide, and labor shortages mean their calendars fill quickly. LK Homes mitigates this with established subcontractor relationships and realistic scheduling, but no honest builder can pretend labor conditions don’t affect timelines.
Phase 6: Drywall, Interior Finishes & Trim (6–10 Weeks)
Once rough inspections are passed, we close up the walls and start making the space feel like a home. This is typically a 6–10 week phase, depending on the size and level of finish you choose.
Drywall: Hanging, taping, mudding, sanding, and texture. Each coat needs proper drying time in Florida’s climate.
Cabinetry, doors, and trim: Kitchen and bath cabinets, interior doors, baseboards, and custom woodwork if specified.
Flooring and paint: Tile, LVP, or other flooring, plus interior painting and touch-ups.
Again, labor availability is the wild card. Statewide construction labor shortages—especially in trades like drywall, flooring, and trim—mean that keeping a barndominium build on schedule requires a builder who has real, ongoing relationships with subs and a reputation for paying on time and running organized jobs. That’s part of how LK Homes keeps our Florida barndominium build time predictable when others slip by months.
Phase 7: Exterior Finishes, Site Work & Final Details (2–4 Weeks)
While interiors are wrapping up, we complete the exterior so your barndominium looks finished and functions correctly on your land. This usually takes 2–4 weeks, overlapping with interior work where possible.
Exterior finishes: Final siding details, trim, porches, gutters, and exterior doors and windows if not already installed with the shell.
Site work: Final grading, basic driveways, and any required drainage improvements.
Weather can still impact this stage, but at this point you’re usually inside your 8–12 month overall window, and the finish line is in sight.
Phase 8: Final Inspections & Certificate of Occupancy (1–3 Weeks)
To legally move in, you need a certificate of occupancy from your local building department. That means passing final inspections for building, electrical, plumbing, HVAC, and any specialty systems. This final phase is usually 1–3 weeks, depending on inspector availability and whether any punch-list corrections are needed.
You can verify your builder’s license and standing anytime through the Florida Department of Business and Professional Regulation. LK Homes encourages clients to do this for every contractor they’re considering. A clean record and active license are non-negotiable when you’re trusting someone with a six- or seven-figure project.
A Cautionary Story: The “3-Month” Barndo That Took 11 Months
One of our clients, a landowner in Central Florida, came to LK Homes after a rough first experience. Their first barndominium was sold by a national kit supplier with a “3-month timeline” in bold letters across the brochure. That number sounded great, so they signed, moved into temporary housing, and waited.
What they didn’t realize was that the 3-month estimate only covered shell erection—and even that assumed design, engineering, and permitting were already complete. The quote excluded:
Architectural design and structural engineering
Permitting, site work, and foundation
Full interior buildout—MEP, drywall, finishes, everything that makes it livable
By the time they finally moved in, they had spent 11 months in temporary housing—eight months longer than they had budgeted for. The shell did go up quickly, but the rest of the work was pieced together with local trades, each on their own schedule, with no single builder managing the full process.
For their second structure on the property, they hired LK Homes. We gave them an honest 9-month estimate from design through CO for a slightly larger barndominium. We built in realistic time for design, permitting, and interior trades. The final move-in date landed within two weeks of our original schedule. No surprises, no extra months in a rental, no guessing about when to line up furniture deliveries.
📌 Lesson: A “3–4 month” promise that ignores design, permitting, and interior buildout is not a fast build. It’s an incomplete one.
A Builder’s Perspective: Why Barndominium Timelines Are So Misleading
Speaking frankly as a Florida barndominium builder: timeline estimates are often used as sales tools, not planning tools. Kit suppliers, and even some builders, highlight the fastest, cleanest part of the process—the shell—and conveniently ignore everything that happens before and after it.
When you ask, “How long does it take to build a barndominium in Florida?” the only honest answer has to include:
Design and engineering time before permits can even be submitted (6–10 weeks)
Permitting timelines that vary by county (3–8 weeks on average)
Site work, foundation, and utilities (3–6 weeks)
The interior buildout that’s most affected by Florida’s ongoing labor shortages
Buyers who understand this full picture before they start are the ones who end up moving in on schedule. They plan their lease with buffer time, align their financing draws with real milestones, and avoid the panic that comes from chasing an artificial deadline that was never achievable in the first place.
Six Ways to Keep Your Florida Barndominium on Schedule
Finalize your floor plan before permitting begins. Mid-build design changes are the number one client-driven cause of delays. Locking in your layout before engineering and permitting eliminates most of them and keeps the schedule intact.
Avoid design changes after engineering is complete. Every post-engineering change ripples through structural calcs, MEP plans, and sometimes permits. That can easily add 4–8 weeks. If something isn’t mission-critical, stick with the plan and move in on time.
Choose a builder with strong subcontractor relationships. In 2025 and beyond, labor availability is the biggest schedule risk—especially for interior trades. Builders like LK Homes who consistently feed quality work to subs tend to get priority on their calendars. That matters more than any promise on a brochure.
Align your financing draw schedule with actual build milestones. Work with your lender and builder to structure draws that match real phases: slab, shell, rough-in, drywall, finishes, and CO. When funding is aligned with reality, you avoid cash-flow hiccups that can stall the job.
Build buffer time into your lease or temporary housing plan. Even with a well-run project, weather, inspections, or trade availability can shift dates by a few weeks. If your lease ends the same week as your projected CO, you’re putting yourself under unnecessary pressure. Give yourself a 30–60 day cushion.
Understand your specific county’s permitting rhythm. Florida has made big strides in permit processing, but Marion is not Miami, and Levy is not Pinellas. Ask your builder for county-specific expectations instead of statewide averages.
Rethinking “Fast”: Why a Realistic Schedule Beats a Rushed One
Here’s the mindset shift that saves buyers the most money and stress: a barndominium built right on a realistic schedule is worth far more than one rushed to hit an artificial deadline. Cutting corners to “make a date” usually shows up later as warranty calls, comfort issues, or costly fixes—none of which are cheaper than a few extra weeks of planning up front.
When you internalize that your Florida barndominium build time is 8–12 months from design through CO—and you plan your life and financing around that—you’re in control. The shell still goes up fast. The difference is that the rest of the process is managed just as carefully, instead of being treated as an afterthought.
How LK Homes Manages the Full Barndominium Construction Schedule
LK Homes, “Building Dreams Within Reach,” focuses on complete Florida barndominium builds—not just shells. Our approach is simple but rare: we tell you the truth about time, then we manage the job to that truth.
We provide a detailed phase-by-phase construction schedule before breaking ground, including design, permitting, site work, shell, interior, and inspections.
We communicate proactively at every phase so you know what’s happening next week, not just what happened last week.
We do not overpromise move-in dates to win contracts. Our goal is to hit realistic dates, not fantasy ones.
The steel shell’s 4–6 month advantage over traditional framing only turns into a faster total build when the entire process is managed from day one. That’s where a full-service builder like LK Homes makes the difference between an 8–9 month reality and a 3–4 month promise that turns into an 11-month headache.
FAQ: Florida Barndominium Build Time & Timelines
1. How long does it take to build a barndominium in Florida from start to finish?
For a full, move-in-ready home—including design, engineering, permitting, site work, shell, interior buildout, and inspections—plan on 8–12 months. The lower end assumes a straightforward design, responsive county, and good weather; the higher end accounts for more complex builds and slower jurisdictions.
2. Why do some companies say they can build my barndominium in 3–4 months?
Because they’re usually quoting shell erection time only. That might cover the steel shell once the slab is ready and materials are on site, but it rarely includes design, engineering, permitting, site work, interior buildout, final inspections, or certificate of occupancy. Always ask what is—and isn’t—included in any timeline you’re given.
3. How fast is steel shell erection compared to wood framing?
Once the foundation is in place and the components are delivered, a typical Florida barndominium steel shell can be erected in about 7–14 days, sometimes up to three weeks on larger or more complex projects. That’s significantly faster than traditional wood framing, which often takes several weeks or more on a similar-sized home.
4. What causes most delays in a barndominium construction schedule in Florida?
The biggest delay drivers are mid-build design changes, labor shortages in interior trades, and county-specific permitting or inspection bottlenecks. Weather can also slow site work and exterior finishes. Finalizing your design early, choosing a builder with strong subcontractor relationships, and building in schedule buffer go a long way toward keeping your project on track.
5. How does LK Homes help keep my barndominium build on schedule?
LK Homes creates a phase-by-phase construction schedule before breaking ground, then manages the project to that schedule with proactive communication. We emphasize complete design before permitting, realistic allowances for your specific county’s permitting process, and coordinated scheduling with trusted subs. We won’t promise a date we can’t defend—and we work hard to hit the dates we do commit to.
Ready to Talk About Your Florida Barndominium Timeline?
If you’re serious about building a barndominium in Florida and you want a builder who will give you straight answers about timing—not just the fastest number on a sales sheet—LK Homes is ready to talk. We’ll walk your land, review your goals, and build a realistic schedule that lines up with your housing plans and financing, so you can move from “someday” to a clear, reliable path to move-in day.
Schedule your free consultation with LK Homes today and let’s map out what your barndominium build timeline in Florida really looks like—start to finish.
